Rules for Editing Change Details Data

In the Change Details view, there are a number of rules that dictate when you can edit data. In general, you can edit a control account, work package, or activity if it is in-progress, but not if it is complete. If you have activities below a work package, the activities drive the work package dates so they cannot be edited manually. Similarly, if you have resource assignments on an activity, you cannot manually add costs to the work package. These rules enforce the cost/schedule integration.

Review the Change Management Process for a detailed description of each step in the change request process.

This topic includes rules for working with:

Rules for Working With:

Description

Change Details View

The Change Details view is designed to allow CAMs to edit only their own work. For example, if a Contract Change Request contains several control accounts, each CAM can see all control accounts in the Change Details view but can only edit the control accounts for which they are the CAM.  This security is based on the role in the Assigned To column of the current workflow step and works for any control account-level code listed in User Field Mapping (for example, the Manager (CAM) field). Since the process uses the user field in the data, using the Reassign feature doesn’t allow the assignee to edit data in the Change Details view.

In addition to the above security setting, you cannot edit data in the Change Details view if any of the following are true:

  • The in-progress step status is In Approval or the Completed Step Status is Complete. The only exceptions are notes and links which you can modify even if the control account Completed Step Status is Complete.

  • The workflow status is Closed or Canceled; in which case, the change details information has been deleted and you cannot access the view.

Edit Costs in the Change Details View

With all change requests, you should enter changes to the schedule before editing time phased costs. This will help ensure that the work package dates are correct before you start entering costs. If the work package dates move, the time phased costs will have to be respread into the new dates which may cause a change in the cost due to rate escalation.

For example, when editing a forecast that goes directly to Cobra, you should update the forecast dates in the schedule using Enter Progress before creating a Forecast Change Request and entering changes on the Cost tab. See Forecast Change Request.

Control Accounts

Control Account Dates

Control account dates always exactly span the dates of all work packages within the control account. When a work package expands, because an activity date changes or because of a manual date entry, the control account start and/or finish date changes to exactly span the new work package dates.

Control Account Costs

Editing costs depends on the level of the change class selected in Workflow Type Configuration. If the change class is at the control account level, you can only add resource assignments at the control account level and the cost grid is disabled at the work package level.

Work Packages

Add or Delete a Work Package

Add a Work Package

You can add a work package if all of the following are true:

  • The control account is not complete.

  • You create the work package and the workflow steps have not yet started.

  • The Create or Delete Work Packages option is selected on the Change Details tab in Workflow Type Configuration.

Delete a Work Package

You can delete a work package in the Change Details view when:

  • The Create or Delete Work Packages Workflow Type Configuration option is selected.

  • The work package is planned.

  • The change request type is a new or change amount and the work package is not in the live project OR,

  • The change request  type is a replacement of existing time phased data and:

  • The change class is a budget type and the only budget class in the live project work package is the target class (that is, the budget class in the When Workflow is Complete, Move to Class Workflow Type Configuration option OR

  • The change class is a forecast type and there are no budget classes in the live project work package.

Work Package Dates

When activities are assigned to the work package, the work package dates always exactly span the dates of all activities within the work package. When an activity start and/or finish date changes, the work package date span changes to exactly span the activity dates.

Editing Work Package Dates

You can edit work package dates when:

  • You add a new work package.

  • There is no schedule attached to the project.

  • There are no activities associated with the work package.

  • There are activities associated with the work package, the change class is a forecast class and the Create, Edit, or Delete Activities in Workflow Type Configuration is unchecked.

See Respread Costs to learn how costs are respread when work package requested baseline dates are changed.

Work Package Costs

Editing costs depends on the level of the change class associated with the workflow type. If the change class is at the work package level, you can only add resource assignments at the work package level.

You can always edit work package costs if the Create, Edit, or Delete Activities option on the Change Details on Form tab of the Workflow Type Configuration form is selected.

If the Create, Edit, or Delete Activities option is not selected, you can edit the cost data at the work package level if there are no activities with resource assignments below the work package. This is because the costs are going to come from the schedule. You will be able to see the costs in the workflow steps that occur after the scheduler has applied the changes and the step action Cost Process = Integration has occurred.

During data entry, Project Preferences such as Allow scope change in CA or WP do not prevent editing of data in the Change Details view. Use the integration wizard configurations to uphold settings when activity assignments are loaded from the schedule.

Insert an Activity below a Work Package

You can insert a new activity below a work package if all of the following conditions are true:

  • The work package status is In Review or New.

  • There is a schedule linked to the project.

  • The work package is not complete.

  • The work package is in progress and the Baseline Finish Date is after the Status Date.

  • There is no activity already linked to the work package, or there is an activity but the work package is not linked to the activity ID, or the work package is not limited to one activity (by selecting the Limit the Work Package to One Activity option on the Projects form Schedule Integration tab).

Activities

Insert an Activity

You can insert an activity if all of the following are true:

  • The work package Completed Step Status is not Complete.

  • The Create, Edit, or Delete Activities option on the Change Details on Form tab of the Workflow Type Configuration form is selected.

  • The Limit the Work Package to one activity option on the Schedule Integration Tab of the Projects Form is not checked or the Limit the Work Package to one activity option is checked and there are no existing activities for the work package.

  • The Activity ID is not linked to WP on the Schedule Integration Tab of the Projects Form.

Edit an Activity

  • You can edit an activity if all of the following are true:

  • The work package Completed Step Status is not Complete.

  • The Create, Edit, or Delete Activities option on the Change Details on Form tab of the Workflow Type Configuration form is selected.

Edit a Resource Assignment

If the Workflow Type Configuration option Load the Change into Cost System as is set to A New or Change Amount, you will be unable to edit existing resource assignments. In order to delete a resource assignment, or reduce hours, you must insert a new line and enter a negative value to indicate a change. In order to increase hours, you must insert a new line and enter a positive value to indicate a change. Upon final approval of the change request, the difference between the two values is rolled into the final budget.

For example, if a painter has 800 hours assigned and you want to reduce the hours to 600, you must insert a new line and add a painter resource assignment with an amount of -200 hours. Upon final approval, the painter resource assignment will have 600 hours rolled into the budget.

If the Workflow Type Configuration option Load the Change into Cost System as is set to A New or Change Amount, you will be able to edit existing resource assignments.

Delete an Activity

If the Workflow Type Configuration option Load the Change into Cost System as is set to A New or Change Amount, you will be able to delete activities.

Activity Dates

Activities are at the lowest level. Their start date is based on the work package start date and their finish date is based on the work package start date plus the activity duration. If you delay the activity start date by adding a relationship or adding a constraint date, a new finish date is calculated by adding the duration to the start date.

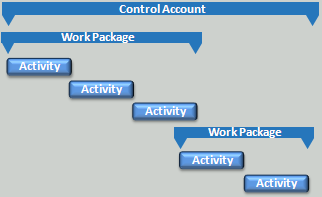

In the example below, the control account spans two work packages. Each work package spans the activities within that work package.

Activity with Zero Duration

When you add a new activity to the Change Details view grid, if you want to use the activity as a milestone, you can change the duration to zero on the General tab in the Duration field. In this case, the activity displays as an ASAP activity type with a zero duration in the Open Plan Add-In. You can change the activity type in the Open Plan Add-In if needed.

Time Phased Data

Under most circumstances, you will not be able to edit data before the status date. You can never edit a forecast before the status date. You can only edit budget before the status date if the Cobra project field setting (Prevent editing of historical time phased values) indicates that you can edit historical time phased budget.

EVT, Milestones/Steps and Earning Rules

Edit an EVT, or Milestone/Step

  • You cannot edit the EVT, milestones, nor steps if the change class is a forecast class.

  • You can edit the EVT when a work package status is Planned or In Progress.

  • You cannot edit or delete a completed milestone or step.

  • Milestone dates cannot be edited to be outside of the work package dates.

Links

Links added to the control account, work package, or activity in the Change Details view can be viewed from the Cost Analysis and Schedule Analysis views. If a change request is canceled or deleted, the links are not deleted unless they were associated to a work package or activity that was added in the unapproved change request. These links are deleted when the change request is canceled or deleted.
