Schedule Traceability Dates Report Overview

Use the Schedule Traceability Dates report to verify cost and schedule alignment. When you choose to sort or group the data by WP_NO, the report will display the activities linked to the work package and highlight the date in red if the work package date does not match the corresponding activity date.

When there are many activities to one work package, the report will highlight the activity that is outside the work package dates. For example, if the activity baseline start date is less than the work package baseline start date, or if there is an actual date in the schedule but there is no corresponding actual date on the work package, both the activity and work package baseline start dates will be highlighted.

Report Options

You can use the Options dialog box to customize the report. Click  in the Options column to display the Schedule Traceability Dates Options dialog box, which includes the following tabs:

All tabs on the Options dialog box share some common options and buttons.

Filtering the Data

You can specify either specific records or criteria when you define the filter that the system uses when creating the report. Click in the Selection column to display the Control Account Search Dialog Box.

For more information, see Modify Standard Reports and Specifying Criteria vs. Specific Records (Values).

Generate the Report

You can generate this report from the following areas:

Sample Report

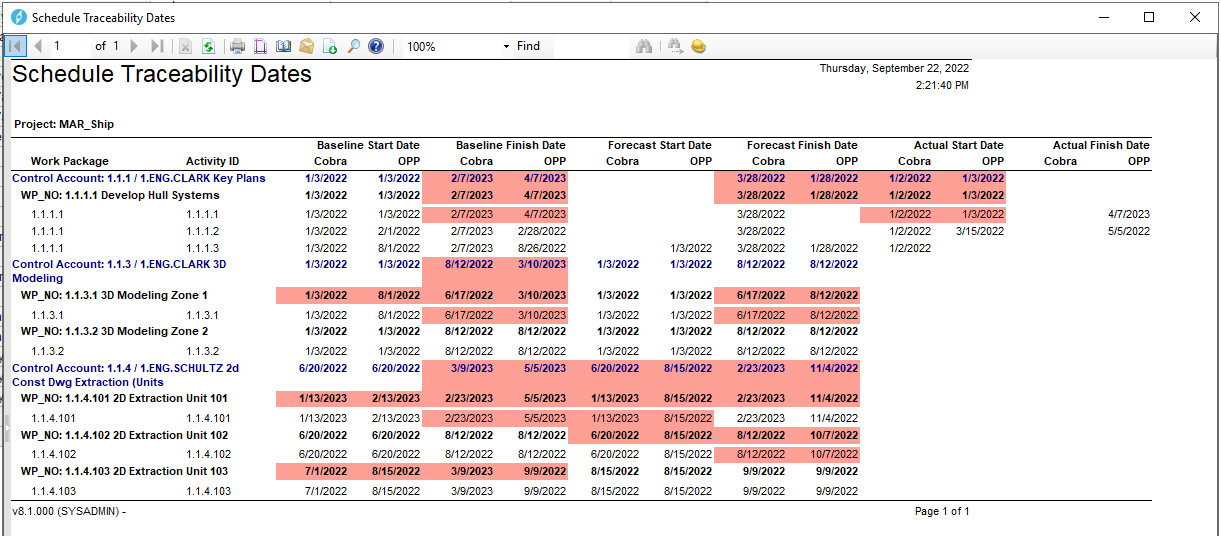

Here is a sample Schedule Traceability Dates report.

Notice that the start date and finish date have similar conditions:

Conditions Under Which Dates are Highlighted

Field Highlighted

Highlight Condition

Baseline Start Date

If the schedule Baseline Start date is less than the cost Baseline Start date.

Baseline Finish Date

If the schedule Baseline Finish date is greater than the cost Baseline Finish date.

Forecast Start Date

If the schedule Forecast Start date is less than the cost Forecast Start date.

Forecast Finish Date

If the schedule Forecast Finish date is greater than the cost Forecast Finish date.

Actual Start Date

If the schedule Actual Start date is less than the cost Actual Start date.

Actual Finish Date

If the schedule Actual Finish date is greater than the cost Actual Finish date.

What do you want to do?

Review the report procedures (use, modify, edit, format, sort, and archive reports)
